LAWN KING, INC.:Sales and Operations Planning
Teaching Notes
3
The level production strategy is shown in Exhibit 1 attached. A level of 100 workers is used for
September through February. This level is then phased down to 85 and then to 49 workers at
the end of the year in order to reach an ending inventory of about 3700 units. It is not possible
to use a completely level strategy in this case without significant stockouts or a larger ending
inventory than desired. Thus an arbitrary initial level of 100 workers is selected with a reduction
in work force later in the year. Other levels could also be selected.
The second strategy, shown in Exhibit 2, is a level strategy with overtime. In this case we
choose a level of 85 regular workers through May, and then phased down to 52 workers at the
end of the year to achieve an ending inventory level of 3700 units. Overtime is used in the
months of December through May to meet the peak demands. Other profiles of level production
and overtime could be selected.
Note, the ending inventory in all strategies should be the same in order to insure a comparable
basis of costing. Students often overlook this point and, as a result, arrive at very different cost
estimates.
The third strategy is to chase demand as shown in Exhibit 3. The chase strategy matches
demand in Sept through Feb. Then a maximum of 200 workers in used in March and April while
inventory is worked off and the level of workers is phased down to chase demand and end the
year with 3700 units.
The fourth strategy is a two-shift strategy, shown in Exhibit 4. This strategy starts with a level of
60 workers in Sept through Dec (first shift) and then doubles the level of workers to 120 (second
shift) from Jan through May. The second shift is phased down to arrive at the same ending
inventory as the rest of the strategies.
In order to evaluate these four strategies we will need to make various assumptions about costs
and resources. The first assumption is the nominal production rate of a worker in a month.

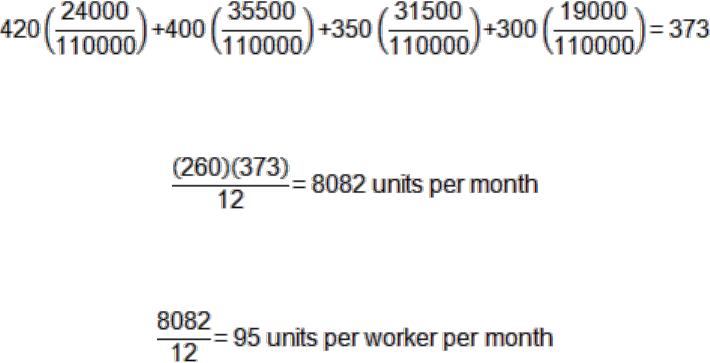

Using the data from Exhibit 4 in the case, an average daily production of 373 units is computed
as the following weighted average:
Since there are 260 production days in a year (52 weeks x 5 days per week), the average
monthly production is 8,082 units:
The initial variable work force level is 85 workers (excludes 10 maintenance and 5 office
workers). The production per direct (or variable) worker is therefore:
