Chapter 04 – Capital Budgeting
8
©2018 McGraw-Hill Education. All rights reserved. Authorized only for instructor use in the classroom. No
reproduction or further distribution permitted without the prior written consent of McGraw-Hill Education.

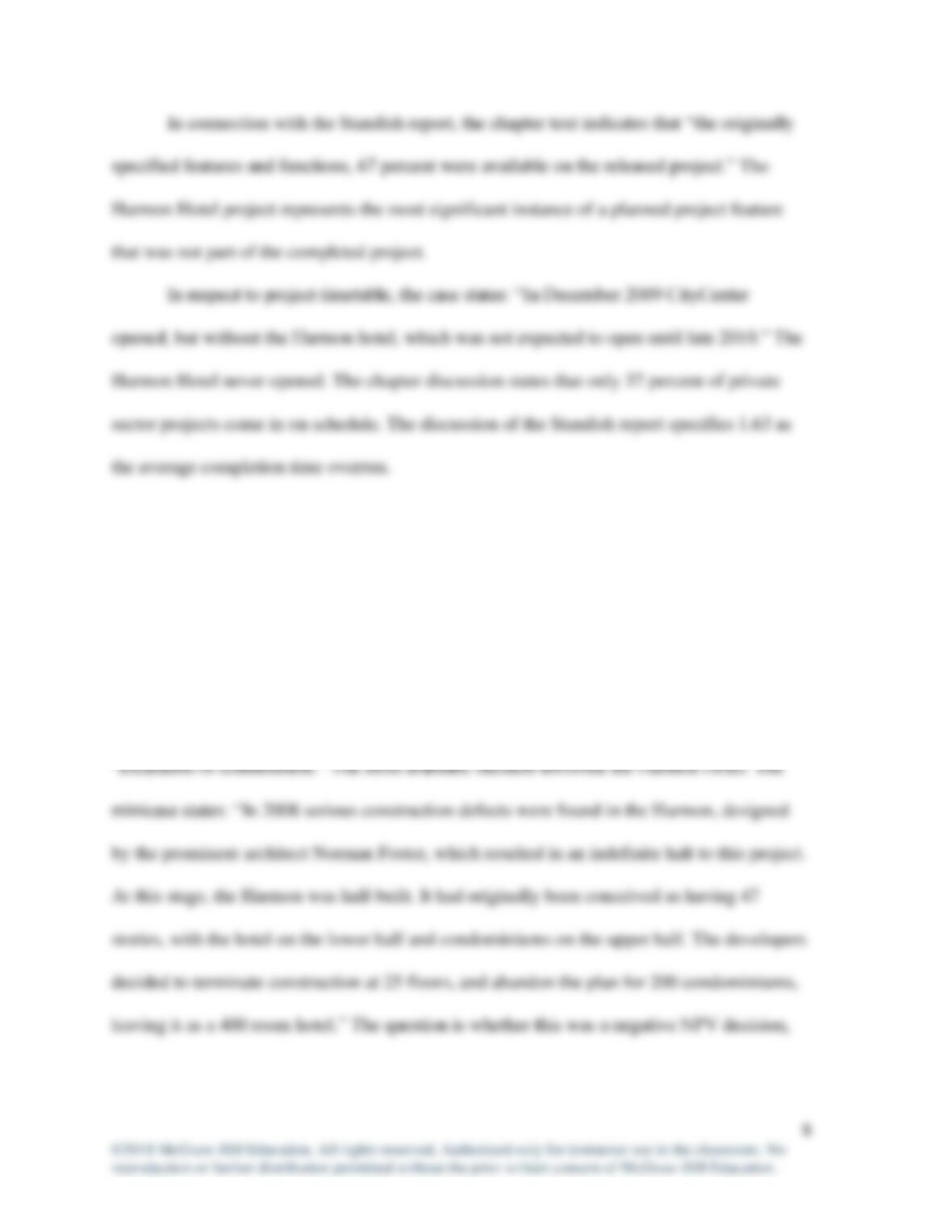

In connection with the Standish report, the chapter text indicates that “the originally
specified features and functions, 67 percent were available on the released project.” The
Harmon Hotel project represents the most significant instance of a planned project feature
that was not part of the completed project.
In respect to project timetable, the case states: “In December 2009 CityCenter
opened, but without the Harmon hotel, which was not expected to open until late 2010.” The
Harmon Hotel never opened. The chapter discussion states that only 37 percent of private
sector projects come in on schedule. The discussion of the Standish report specifies 1.63 as
the average completion time overrun.
2. Once the project was underway, sunk costs were inevitable. At issue is whether negative
surprises, such as cost overruns, labor disputes, safety infractions, and shrinking revenues left
MGM in a position where they would have been better off terminating the CityCenter project
than continuing it.
According to the minicase, MGM made decisions that suggest they did not engage in
