Chapter 14
Real Options
ANSWERS TO BEGINNING-OFCHAPTER QUESTIONS
14-1 Financial options deal with securities like stocks and debt instruments, whereas real options
deal with physical assets like capital budgeting projects. There are many different types of
real options, ranging from those related to whole plants to options on commodities such as
oil, electricity, gas, and copper. We focused primarily on real options as they relate to
The text discusses several approaches to dealing with real options:
Ignore them. Just use traditional DCF approaches to capital budgeting.
Recognize them and deal with them in a qualitative, judgmental manner.
Take a decision tree, or scenario analysis, approach, and find the NPV of a project with
In the chapter BOC spreadsheet model, we analyze a project’s timing option using the
first 4 procedures. The Tool Kit for the chapter extends the analysis to growth, flexibility,
and abandonment options.
Some real options are inherent in capital budgeting, but others can be created. For
Answers and Solutions: 14 – 1
14-2 See the BOC model for an example of a scenario analysis and a BlackScholes analysis for
an investment timing option. Similar analyses for growth and abandonment options are
contained the chapter Tool Kit.
Some controversy exists regarding the use of decision trees versus formal option
pricing models. The primary advantage of the decision tree approach is that it is relatively
easy to implement, and it is easy to explain to decision makers. One doesn’t even need to
discuss options per se—simply calculate the project’s NPV with and without the option,
The bottom line, to us, is that if one focuses just on a particular decision, such as the
project in our BOC model, where we consider the decision the decision to proceed now or
to wait, there is no significant advantage to either method. The decision tree approach is
more straightforward and easier to explain to managers, but both lead to the same decision
Answers and Solutions: 14 – 2

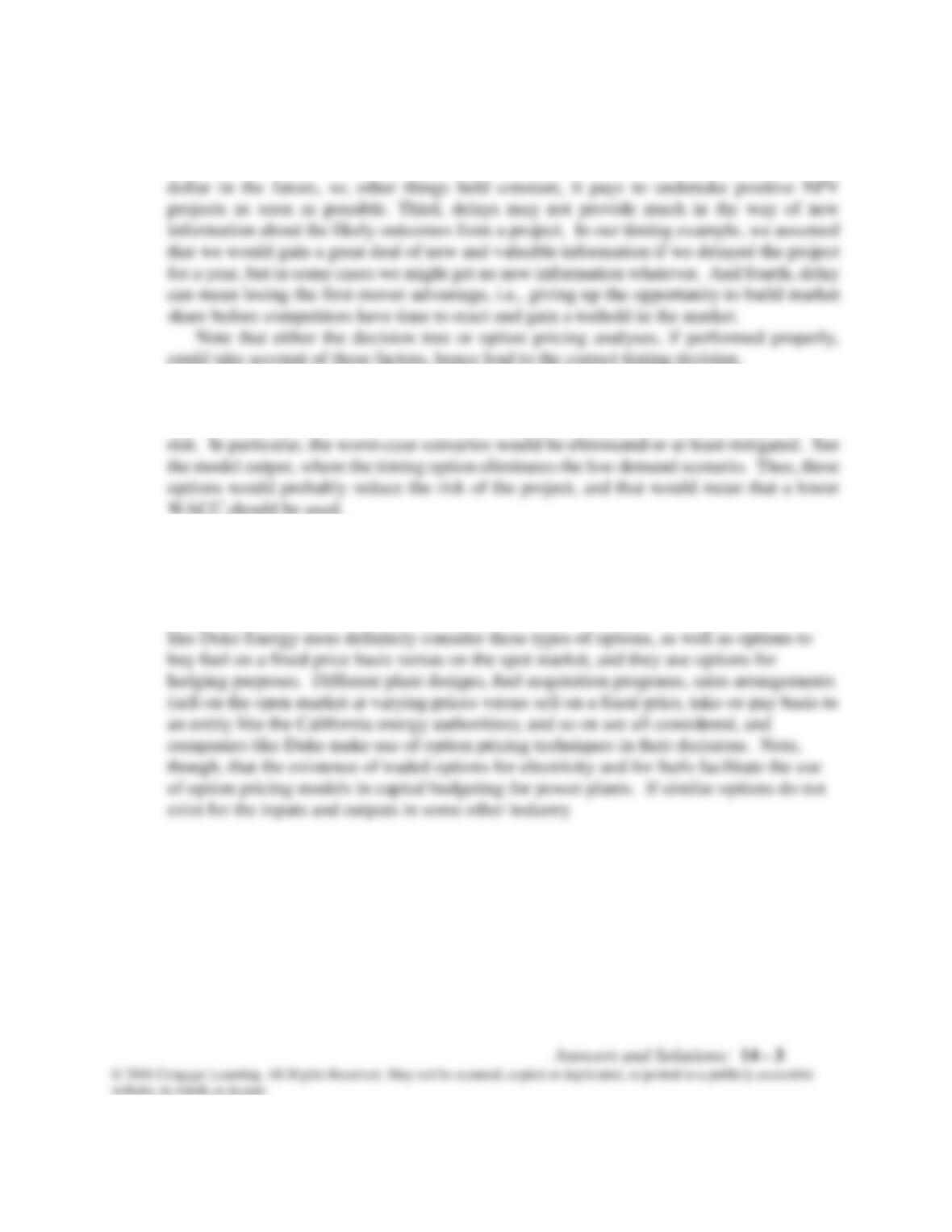

14-3 Several factors should be considered. First, if projects are never undertaken, then they
never provide any benefits in the form of NPV, so companies do need to invest at some
point. Second, and related to the first point, a dollar of cash flow today is better than a
14-4 In general, each of these options would increase the expected NPV and reduce the standard
deviation and coefficient of variation of the expected NPV, which would mean a lower
14-5 The answer to this question has been discussed in the preceding answers. The company
could delay the decision to get more information on the demand for power, it could build
in flexibility with regard to fuel used (gas, oil, or coal), and it could consider the
possibility of abandonment if things turned out badly. Companies in the power industry
ANSWERS TO END-OF-CHAPTER QUESTIONS

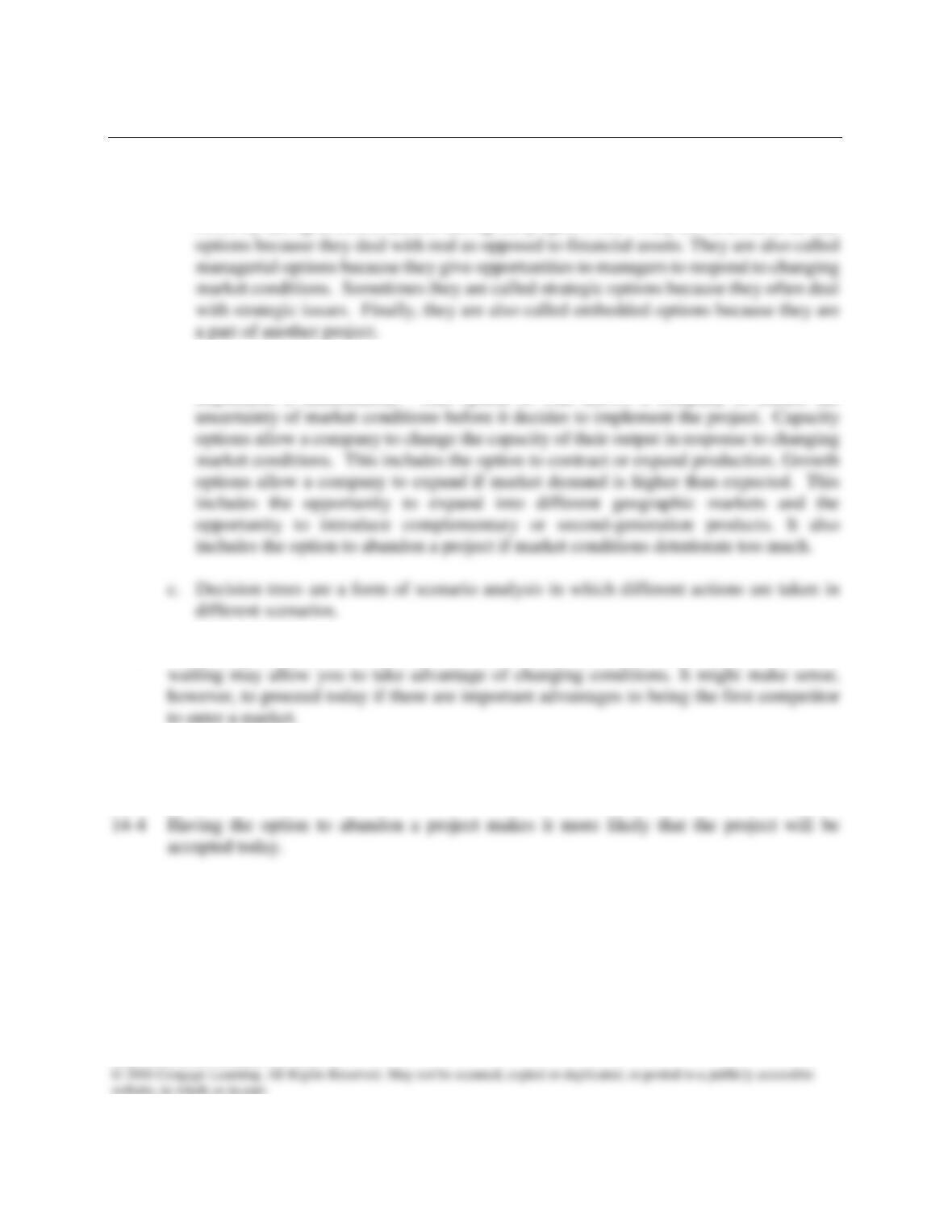

14-1 a. Real options occur when managers can influence the size and risk of a project’s cash
flows by taking different actions during the project’s life. They are referred to as real
b. Investment timing options give companies the option to delay a project rather than
implement it immediately. This option to wait allows a company to reduce the
14-2 Postponing the project means that cash flows come later rather than sooner; however,
14-3 Timing options make it less likely that a project will be accepted today. Often, if a firm can
delay a decision, it can increase the expected NPV of a project.
Answers and Solutions: 14 – 4
SOLUTIONS TO END-OF-CHAPTER PROBLEMS
14-1 a. 0 1 2 20
├─────┼─────┼────── ────┤
20 3 3 3
b. Wait 1 year:
PV @
0 1 2 3 21 Yr. 1
Tax imposed | | | | |
50% Prob. 0 20 2.2 2.2 2.2 15.45
r= 13%
Answers and Solutions: 14 – 5
14-2 a. 0 1 2 3 4
├─────┼─────┼─────┼─────┤
8 4 4 4 4
NPV = $4.6795 million.
b. Wait 2 years:
If the cash flows are only $2.2 million, the NPV of the project is negative and, thus,
would not be undertaken. The value of the option of waiting two years is evaluated as
10%
Answers and Solutions: 14 – 6
14-3 a. 0 1 2 20
├─────┼─────┼────── ────┤
300 40 40 40
b. Wait 1 year:
NPV @
0 1 2 3 4 21 Yr. 0
NPV @
0 1 2 3 4 21 Yr. 0
| | | | | |
50% Prob. 0 300 30 30 + 280 0 0 $27.1468
13%
r = 13%
Answers and Solutions: 14 – 7
14-4 a. 0 1 14 15
b. 0 1 14 15
| | | |
6,200,000 1,200,000 1,200,000 1,200,000
d. Since the project’s NPV with the tax is negative, if the tax were imposed the firm would
abandon the project. Thus, the decision tree looks like this:
NPV @
12%
12%
Answers and Solutions: 14 – 8
e. NPV @
0 1 Yr. 0
50% Prob. | |
Taxes NPV = ? 1,500,000 $ 0.00
+300,000 = NPV @ t = 1
r = 12%
}wouldn’t do
Answers and Solutions: 14 – 9
14-5
a.
0 1 2
40% Prob. | | |
Good 20,000 25,000 25,000 NPV = 23,388
b.
0 1 2 3 4
40% Prob. | | | | |
Good 20,000 25,000 25,000 25,000 25,000
The NPV of the top row is 79,247 20,000 17,800 = 41,447.
The NPV of the bottom row is still 11,332, as it was in part a.
The expected NPV, E[NPV], is 41,447 (0.40) 11,332 (0.60) = $9,786.
r = 10%
r = 10%
Answers and Solutions: 14 – 10
14-6 P = PV of all expected future cash flows if project is delayed. From Problem 14-1 we
know that PV @ Year 1 of Tax Imposed scenario is $15.45 and PV @ Year 1 of Tax Not
Imposed Scenario is $26.69. So the PV is:
From Excel function NORMSDIST, or approximated from the table in Appendix A:
N(d1) = 0.5670
N(d2) = 0.4628
Using the Black-Scholes Option Pricing Model, you calculate the option’s value as:
14-7 P = PV of all expected future cash flows if project is delayed. From Problem 14-1 we
know that PV @ Year 2 of Low CF Scenario is $6.974 and PV @ Year 2 of High CF
Scenario is $13.313. So the PV is:
From Excel function NORMSDIST, or approximated from the table in Appendix A:
N(d1) = 0.9713
N(d2) = 0.9601
Using the Black-Scholes Option Pricing Model, you calculate the option’s value as:
14-8 P = PV as of time zero of all expected future cash flows if the project is repeated starting
in year 2. Note it includes both the good cash flows and the bad cash flows since as of
now, we don’t know which outcome will result, and P excludes the $20,000 investment in
the franchise.
0 1 2 3 4
40% Prob. | | | | |
Good 25,000 25,000
r = 10%
Answers and Solutions: 14 – 12
The time to expiration is the time you decide whether or not to extend the franchise, and is
at the end of year 2.
Although the problem stated to assume the variance of the project’s rate of return was
0.2025, we’ll also calculate it using the direct method. First calculate the rates of return
using the decision tree. To do this, calculate the present values of the two branches as of
the exercise date, year 2, and the rates of return assuming the initial value of the investment
was P = $18,646.
The expected value of these two returns is 52.54(0.40) – 31.78(0.60) = 1.95% [Note: this
isn’t 10% as you might hope! The 2-year returns are 43,388/18,646 – 1 = 132.69% in the
Answers and Solutions: 14 – 13
To calculate the variance of the project’s returns using the indirect method, first calculate
the standard deviation of the value at year 2. The value is either 43,388 (probability 40%)
or 8,678 (probability 60%).
Notice that in this case the direct method and the indirect method give very similar results
for σ.
P = $18,646
From Excel function NORMSDIST, or approximated from the table in Appendix A:
N(d1) = 0.6542
N(d2) = 0.4053
Using the Black-Scholes Option Pricing Model, you calculate the option’s value as:
Answers and Solutions: 14 – 14
